Only One Ford-Class Carrier Is in Service. The Fourth Could Go Back to Steam Catapults.

The Ford-class aircraft carrier is the US Navy's newest supercarrier: one in service, five more planned. What changed from Nimitz, what it costs and why.

Published: by Tim de Vries

Add AeroCorner as a preferred source on Google
Bow view of USS Gerald R. Ford underway on its own power for the first time, April 2017
The U.S. Navy aircraft carrier USS Gerald R. Ford (CVN-78) underway on its own power for the first time. – © U.S. Navy photo by Mass Communication Specialist 2nd Class Ridge Leoni

Get the Newsletter

The latest aviation news and stories sent to your inbox.

Table of Contents

On May 16, 2026, USS Gerald R. Ford sailed back into Norfolk after 326 days away. Its air wing had flown in the Caribbean during the Venezuela operations and struck Iran from the eastern Mediterranean.

Three months later, the White House ordered the Navy to plan how to strip the class’s signature technology out of a future sister ship. The electromagnetic catapults that define the Ford class could give way to steam, the system the class was designed to replace.

Both things are true at once, and that is the Ford class in one sentence. Here is what the class is, how many ships exist, what is actually new about them, and why its newest technology is still being argued over in 2026.

What Is a Ford-Class Aircraft Carrier?

The Ford class is the US Navy’s newest class of nuclear-powered supercarrier, built by Huntington Ingalls Industries’ Newport News Shipbuilding in Virginia. It is the first new carrier design since the Nimitz class. The lead ship replaced the retired USS Enterprise, and later ships take over as the 10 Nimitz carriers retire.

Only one Ford-class ship, USS Gerald R. Ford (CVN-78), is in commission. The Navy plans six in total, and the second, the future USS John F. Kennedy, is due to be delivered in March 2027. Until it arrives, Ford is the lone newcomer among the 11 carriers counted in how many aircraft carriers the US has.

The Ford class at a glance

Builder: Newport News Shipbuilding, Virginia. Ships planned: six (CVN-78 to CVN-83). In service: one, USS Gerald R. Ford, commissioned July 22, 2017. Size: 1,092 feet long, about 100,000 tons. Cost: about $13.3 billion for the lead ship. Signature systems: electromagnetic catapults (EMALS), Advanced Arresting Gear and electric weapons elevators.

How Many Ford-Class Carriers Are There?

Six are planned, one is in service, and every ship under construction has slipped. The Navy’s April 2026 Selected Acquisition Report, the program’s official status filing to Congress, gives these dates.

ShipStatus (October 2026)DeliveryCost
CVN-78 Gerald R. FordIn service since 2017Delivered May 2017$13.3 billion
CVN-79 John F. KennedyPreliminary acceptance, Sept. 29, 2026March 2027$13.2 billion
CVN-80 EnterpriseUnder construction, 42% complete in April 2026March 2031$14.2 billion
CVN-81 Doris MillerUnder constructionFebruary 2034$15.2 billion
CVN-82 William J. ClintonNamed; contract planned FY2029March 2039Not yet set
CVN-83 George W. BushNamedMarch 2043Not yet set
Delivery dates are Navy estimates from the April 2026 Selected Acquisition Report. Costs are procurement costs in then-year dollars from the Congressional Research Service, December 2025.

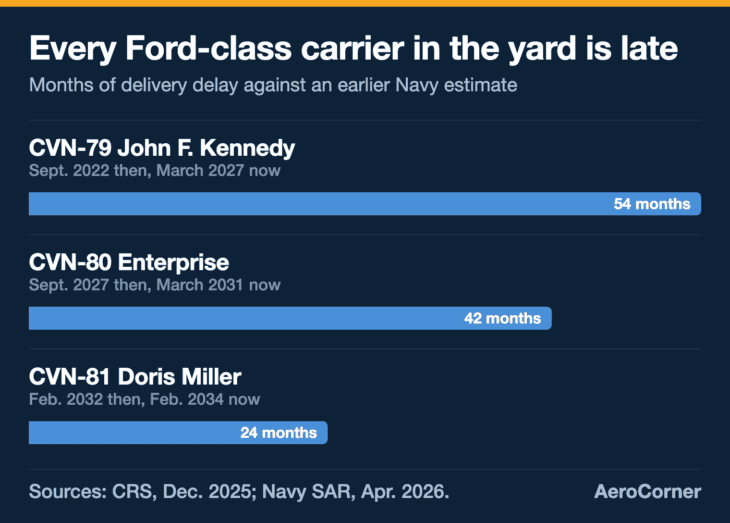

The slips are measured in years. Kennedy was once due in September 2022; the Congressional Research Service counts its delay at 54 months. Enterprise was once due in September 2027, and its contract still says March 2028, but the Navy now projects March 2031, citing “shipbuilder performance and late material delivery.”

Kennedy’s delay is why the 51-year-old USS Nimitz is staying in commission until March 2027. Federal law requires at least 11 operational carriers, and the Navy cannot retire Nimitz before its replacement shows up.

The Navy blamed Kennedy’s slip on certifying its Advanced Arresting Gear and on weapons elevators that were installed more slowly than planned. When the Navy took preliminary acceptance on September 29, 2026, four of the ship’s 11 weapons elevators were still in testing.

How Big Is a Ford-Class Carrier?

The Navy lists the Ford class at 1,092 feet (333 m) long and about 100,000 tons. The design was pitched in 1998 as a large-capacity carrier for 75 aircraft.

In practice it deploys with a standard nine-squadron air wing. On its 2025 to 2026 cruise, Carrier Air Wing 8 brought four squadrons of F/A-18E/F Super Hornets, one of EA-18G Growlers, one of E-2D Hawkeyes, two helicopter squadrons and a logistics detachment. No F-35C squadron was aboard.

From the pier, a Ford looks like a close relative of a Nimitz. The differences that matter are on the flight deck and inside the hull, which is where the Navy spent its money.

What Makes the Ford Different From a Nimitz?

The headline change is the catapult. A Nimitz launches jets with steam catapults. A Ford uses EMALS, the Electromagnetic Aircraft Launch System, which drives the shuttle with a linear induction motor fed by stored energy.

NAVAIR says that gives “more accurate end-speed control and smoother acceleration.” It can be tuned for anything “from lightweight unmanned to heavy strike fighters,” with less stress on the airframe. A steam catapult has no sensors or feedback once a launch starts, so it cannot fine-tune the shove for a light, fragile drone.

Landing changed too. The Advanced Arresting Gear replaces the Mk 7 gear used on Nimitz carriers with water turbines and an induction motor that slow each jet under digital control. The 11 Advanced Weapons Elevators run on electromagnetic motors instead of hydraulics.

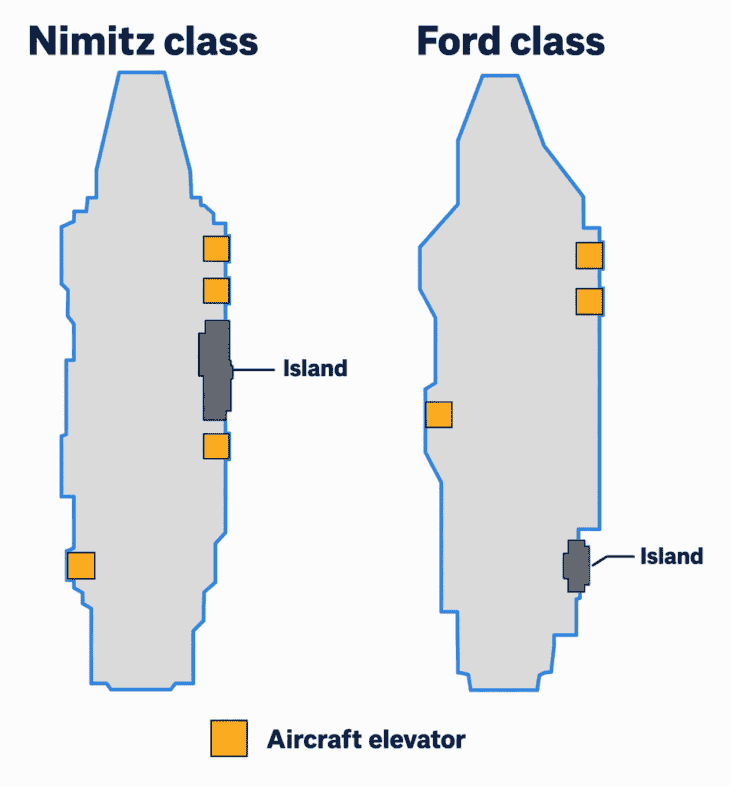

The deck itself was rearranged. The island is smaller and further aft, there are three aircraft elevators instead of four, and fueling stations sit in the deck itself rather than only along the catwalks. The idea is a pit stop: jets refuel where they park instead of queuing at the deck edge.

Below decks, a new reactor plant gives the ship 3.25 times a Nimitz’s electrical generating capacity, according to the Navy’s acquisition report. The Congressional Research Service says the class runs with several hundred fewer sailors and should save about $4 billion per ship over a 50-year life.

The redesign mattered more than the catapults

The Ford was required to sustain 160 sorties a day over a 12-hour flying day, against the 120 a Nimitz demonstrated, and to surge to 270 against 240. In 2014, GAO reported that Navy models showed the ship could meet those numbers primarily because of the flight deck redesign, not because of the new launch and recovery technology.

Ford ran a four-day sustained sortie-rate demonstration in February 2026. The Navy’s current estimates are 172 sorties a day sustained and 284 in a surge, both above the requirement, though the acquisition report still lists the demonstrated figures as “TBD.”

Do the Electromagnetic Catapults Actually Work?

Myth: the Ford's catapults do not work

They do. EMALS and the Advanced Arresting Gear passed 10,000 launches and recoveries in June 2022, and the air wing logged about 12,200 launches on the 2025 to 2026 deployment. The real problem is how often they break: both systems have tested far below the reliability the Navy required.

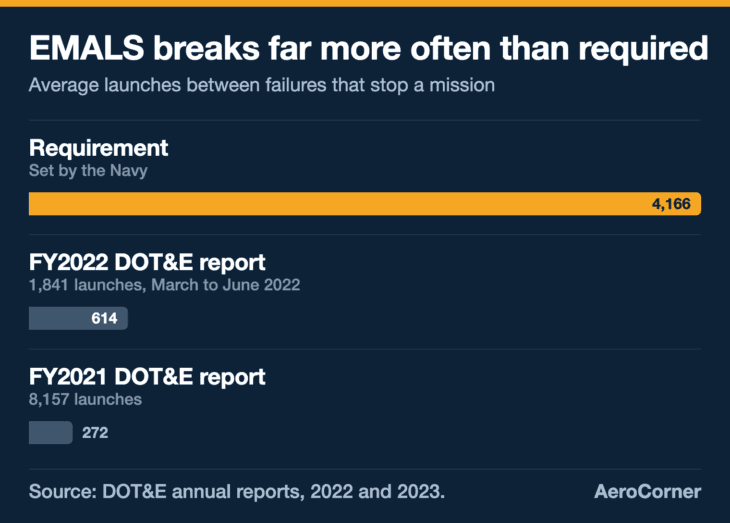

The numbers come from the Pentagon’s own testing office, DOT&E. Its FY2021 report found EMALS averaged 272 launches between failures that took it out of action, against a requirement of 4,166. A shorter test window in 2022 produced 614, still “well below” the requirement.

The arresting gear scored worse against its target: 41 recoveries between failures in the FY2021 report and 460 in 2022, against a requirement of 16,500. The ship was also built without a planned fourth arresting-gear engine, so it cannot rig its emergency barricade net if one engine fails.

The newest report, published in March 2026, says hardware and software upgrades “have produced gradual improvements,” but that the systems “continue to adversely affect sortie generation.” The ship still leans on off-ship technical experts to keep them running.

How the Ford’s launch system stacks up against China’s newest carrier is covered in our comparison of US and Chinese aircraft carriers.

Where Is USS Gerald R. Ford Now?

Since July 7, 2026, USS Gerald R. Ford has been at Norfolk Naval Shipyard in Portsmouth, Virginia, for planned maintenance, with a second work package for fire damage. In September the shipyard’s commander said he still expected to hand it back in about six months.

Getting it to sea took longer than building it. Ford was commissioned in July 2017, but its first deployment did not start until October 2022, more than five years later, held back largely by unfinished weapons elevators.

Nov. 2013

Christened and launched. The hull floats out at Newport News, four years after the keel was laid.

July 22, 2017

Commissioned. President Trump attends the ceremony at Naval Station Norfolk.

Oct.-Nov. 2022

First deployment. A short Atlantic cruise with about 80 percent of a full air wing and more than 1,250 sorties.

May 2023-Jan. 2024

First combat deployment. Extended 76 days after the October 7 attacks on Israel. 239 days, 10,396 sorties.

June 24, 2025

Leaves for an 11-month cruise. Europe and the Arctic first, then the Caribbean from November 2025.

Feb. 28, 2026

Strikes on Iran. Ford launches attacks from the eastern Mediterranean under Operation Epic Fury.

March 12, 2026

Fire aboard. A blaze in the main laundry spaces, not combat-related, damages about 100 sleeping berths.

May 16, 2026

Home after 326 days. 57,713 nautical miles sailed and about 12,200 launches by the air wing.

The 2025 to 2026 cruise was a test of the whole class. The Navy’s homecoming release credited it with Operations Southern Spear and Absolute Resolve in the Caribbean, then Epic Fury against Iran. In the middle of it, the March fire forced repair stops at Souda Bay in Crete and Split in Croatia.

The New York Times reported that the fire spread through vent ducts into berthing for more than 600 sailors and took over 30 hours to put out. NPR reported in May that NCIS and the ATF were investigating whether it was set deliberately. The ship also suffered repeated vacuum toilet failures during the cruise.

Long, but not a record

The 326-day cruise was widely reported as the longest US carrier deployment since the Vietnam War, beating USS Abraham Lincoln’s 294 days in 2020. It is not the all-time record: as AP noted, USS Midway spent 332 days deployed in 1972 and 1973.

For more on the destroyers and support ships that sailed with it, see how a carrier strike group is put together.

Why the White House Wants Steam Catapults Back

President Trump has disliked EMALS since 2017, when he told TIME it was “digital” and “very complicated,” and that the Navy should go back to “goddamned steam.” No order followed then. In October 2025, aboard USS George Washington, he promised an executive order putting steam catapults and hydraulic elevators on new carriers.

It arrived on August 13, 2026, as a presidential memorandum. It gives the Pentagon 60 days to produce “a plan on the required measures to replace the Electromagnetic Aircraft Launch System and Advanced Weapons Elevators with steam and hydraulic systems for the construction of CVN-81.”

The order is narrower than the headlines. It names one ship, Doris Miller, and only the catapults and weapons elevators, not the arresting gear. Ford, Kennedy and Enterprise keep EMALS.

Doris Miller is not a blank sheet either. EMALS-maker General Atomics has said its catapult and arresting-gear work for that ship is about half done, and it warned of “significant cost, schedule, and integration risks.” The Navy, for its part, still argues electromagnetic launch is smoother, adjustable for drones and less manpower-hungry.

The plan was due around October 12, 2026, and no version of it had been made public as of early October.

Separately, Navy Secretary John Phelan said in April that a review was asking whether the Navy is “getting the appropriate bang for our buck” from the Ford over the Nimitz, with CVN-82 and CVN-83 under the closest scrutiny.

How Much Does a Ford-Class Carrier Cost?

USS Gerald R. Ford’s final procurement cost was $13.3 billion in then-year dollars. A 2015 CRS breakdown put about $3.3 billion of the lead ship’s cost into one-time design and engineering for the whole class.

Later ships cost more, not less: $13.2 billion for Kennedy, $14.2 billion for Enterprise and $15.2 billion for Doris Miller. Across all six ships, the Navy’s April 2026 report puts total acquisition at $114.8 billion in then-year dollars.

Each of those ships is meant to serve about 50 years, which is why the catapult argument matters. Whatever goes into Doris Miller in the 2030s will still be launching jets in the 2080s.

So the next time a Ford-class carrier turns up in the news, keep both halves in view. It is the ship the Navy sends when it needs the most airpower on the water, and it is also a design still being tested, repaired and second-guessed nine years after the first one was commissioned.
